How Often Should You Review and Update Your Risk Register?

Ask ten risk managers how often they review their risk register and you’ll get ten different answers. Quarterly. Annually. When we remember. After something goes wrong. The honest truth is that most organisations don’t have a consistent, documented approach, which means their risk register drifts out of sync with reality, and gradually stops being useful as a management tool.

This article gives you a practical framework for determining how often to review your risk register, what should trigger an unscheduled review, how to assign accountability for keeping it current, and what a workable review schedule looks like across different organisation types.

Why Review Frequency Matters

A risk register is only as valuable as its accuracy. An out-of-date register gives you false confidence: it tells you that risks are controlled when controls may have lapsed, that likelihood ratings reflect current conditions when the operating environment has changed, and that treatment actions are progressing when they’ve stalled or been deprioritised.

The consequences of a stale risk register aren’t just administrative. At board level, outdated risk reporting creates governance liability, management is presenting a picture of the organisation’s risk profile that doesn’t reflect reality. In regulated industries, an inaccurate register can signal to auditors and regulators that your risk management program exists on paper but not in practice.

On the flip side, reviewing too frequently, without purpose, creates a different problem. Teams burn out on a process that feels like box-ticking. Reviews happen but nothing changes. Risk owners stop engaging meaningfully because the process seems detached from actual decision-making.

The goal is calibrated frequency: reviewing at a pace that keeps the register accurate without creating unnecessary overhead.

The Two Types of Risk Register Reviews

Scheduled reviews happen at fixed intervals, quarterly, semi-annually, annually, regardless of what’s happening in the business. They’re triggered by the calendar, not by events. Their purpose is to catch gradual drift: risks that have evolved incrementally, controls that have quietly degraded, treatment actions that have been deprioritised without anyone formally deciding to de-prioritise them.

Event-triggered reviews happen when something specific occurs that is likely to affect the risk profile. These are initiated by circumstances, not the calendar. They target specific risks or categories rather than the whole register. They’re often more urgent than scheduled reviews because the circumstances that trigger them, a major incident, a regulatory change, a strategic pivot, demand immediate reassessment rather than waiting for the next scheduled cycle.

Both types are necessary. A mature risk management program uses both: scheduled reviews to catch slow drift, and event-triggered reviews to respond to significant changes as they occur.

How Often Should You Conduct Scheduled Reviews?

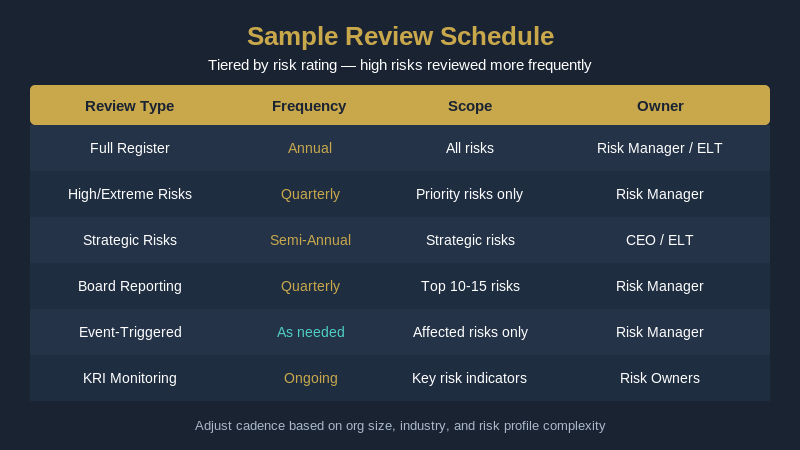

Sample risk register review schedule table, tiered by risk rating and review type

The right scheduled review frequency depends on several factors: the volatility of your operating environment, your regulatory obligations, the maturity of your risk management program, and the size and complexity of your organisation. There is no universal answer, but there are useful guidelines.

Quarterly reviews: high-risk or high-volatility environments

Quarterly reviews are appropriate when your industry is subject to frequent regulatory changes (financial services, healthcare, construction, mining), when your organisation is growing rapidly or entering new markets, when your risk profile has a high proportion of high or extreme risks, or when your board or audit committee expects quarterly risk reporting. At quarterly cadence, each cycle typically covers a targeted subset of the register rather than every risk.

Semi-annual reviews: established organisations with stable risk profiles

Semi-annual reviews work well for organisations that operate in relatively stable regulatory environments, have a mostly mature and well-controlled risk profile, or are in the mid-stages of building a risk management program. Semi-annual reviews typically involve a fuller pass through the register than quarterly reviews, with more time to assess control effectiveness and update treatment actions.

Annual reviews: minimum viable frequency

An annual review is the absolute minimum for any organisation that maintains a risk register. It’s appropriate for small organisations (under 50 staff) with straightforward risk profiles, or established businesses in low-volatility industries with mature, well-embedded controls. For most organisations, annual-only reviews aren’t sufficient to maintain register accuracy. Annual reviews are best used as the comprehensive, deep-dive cycle, reviewing every risk in detail, with lighter-touch semi-annual or quarterly touchpoints in between.

Continuous monitoring: the emerging standard

The most sophisticated risk management programs don’t wait for scheduled reviews at all. They build continuous monitoring into the risk management infrastructure: key risk indicators (KRIs) that are tracked in real time, automated alerts when thresholds are breached, and integration with incident management so that events automatically trigger risk register updates. This doesn’t eliminate scheduled reviews, it makes them more productive, because the scheduled cycle is focused on strategic assessment rather than data gathering.

What Should Trigger an Unscheduled Review?

Beyond the calendar, certain events should always trigger an immediate review of the relevant risks. These triggers aren’t optional, they represent circumstances where waiting for the next scheduled review could mean operating with materially inaccurate risk information.

  • Regulatory or legislative changes: When new laws, standards, or regulatory requirements take effect, or when existing ones change significantly, the compliance risks in your register need immediate reassessment. In Australia, this includes changes to WHS legislation, Privacy Act amendments, the Security of Critical Infrastructure Act, and industry-specific standards (APRA, healthcare).
  • New projects, acquisitions, or significant operational changes: Launching a new product line, entering a new market, acquiring another business, implementing a major technology system, or significantly changing your operating model, all introduce new risks and change the relevance of existing ones.
  • Significant incidents or near-misses: When an incident occurs, especially one that resulted in harm, near-harm, or significant operational impact, the relevant risks need immediate review. The incident has provided real-world evidence about your actual risk exposure. This is the closed-loop principle: every incident is a data point about your risk register. See Integrating Your Risk Register with Incident Management for a detailed treatment.
  • Changes in key personnel: When the person responsible for a risk or treatment action leaves or changes roles, the register needs updating. Significant changes in organisational leadership often warrant a broader review.
  • Market or competitive disruptions: Significant changes in your competitive environment, technology landscape, or economic conditions can alter the likelihood and consequence of strategic and operational risks almost overnight.
  • Insurance renewal or audit preparation: The period leading up to insurance renewal or an external audit is a natural trigger for a review, because your risk register is likely to be scrutinised externally.

How to Structure the Review Process

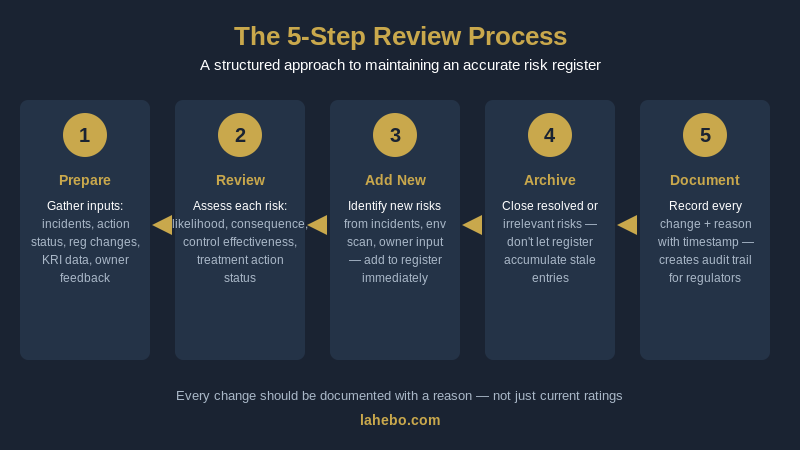

The 5-step risk register review process

A risk register review isn’t simply opening the spreadsheet and confirming that everything looks the same. An effective review follows a structured process that results in genuinely updated risk information.

Step 1: Prepare. Before the review, gather the relevant inputs: incidents and near-misses since the last review; status of treatment actions; regulatory or environmental changes; KRI data; and input from risk owners about whether their risk ratings still feel accurate.

Step 2: Review each risk systematically. For each risk, assess: Is the risk description still accurate? Are the likelihood and consequence ratings still appropriate? Are the controls still in place and functioning? Has the residual risk rating changed? Are treatment actions progressing?

Step 3: Add newly identified risks. The review should include an explicit prompt to consider whether any new risks have emerged since the last cycle. These might come from incidents, environmental scan, strategic discussions, or risk owner conversations.

Step 4: Archive resolved risks. Risks that have been fully controlled to an acceptable level, or that are no longer relevant, should be closed or archived, not left on the register indefinitely. An accumulation of inactive risks reduces the usability of the register.

Step 5: Update and document. Every change made during the review should be documented, not just the change itself, but the reason for it. This creates an audit trail that demonstrates the register is actively managed. A timestamp on each change is essential for demonstrating currency to auditors, boards, and regulators.

Who Should Own the Review?

A common failure in risk register maintenance is unclear ownership. If no one is specifically accountable for driving the review cycle, reviews either don’t happen or happen inconsistently.

The risk manager or risk officer typically owns the review calendar: scheduling reviews, preparing input, facilitating sessions, and ensuring changes are documented. In organisations without a dedicated risk role, this responsibility often falls to the CFO, COO, or a nominated member of the senior leadership team.

Risk owners (the individuals assigned to specific risks) are accountable for the accuracy of their risks between formal reviews. They should be updating likelihood ratings, control status, and treatment action progress continuously, not just during scheduled reviews.

The board or audit committee sets the expectation for review frequency and receives the output. Board-level oversight is what creates accountability for the review cycle to actually happen.

Common Mistakes in Risk Register Reviews

Rating inflation resistance. Risk owners are often reluctant to increase the likelihood or consequence ratings of their risks, because it implies the situation is getting worse on their watch. A good review process creates psychological safety for honest upward revision, and treats increased ratings as evidence of good monitoring rather than poor performance.

Stale treatment actions. Treatment actions with past-due dates that haven’t been updated are one of the most common signs of an unmaintained register. Reviews should be as much about action status as risk ratings.

Reviewing without evidence. The most common review failure is confirming existing ratings without reference to new evidence. A review that produces no changes whatsoever, no matter how stable the environment, is almost certainly not being conducted rigorously.

Register bloat. Over time, registers accumulate risks that were added in response to specific incidents or concerns and never removed. An annual triage, asking whether each risk is still relevant and at the right level of detail, keeps the register usable. For more on what goes wrong in risk registers, see Top 5 Risk Register Mistakes Australian Businesses Make.

No audit trail. A risk register that shows only current ratings, with no history of changes and no documentation of why ratings changed, is difficult to defend to auditors and provides no useful intelligence about how the risk profile is evolving.

How Software Makes Regular Reviews Sustainable

Maintaining a consistent, evidence-based review cycle is genuinely difficult with a spreadsheet. Version control is fragile, audit trails require manual effort, and connecting incidents to risk register updates is entirely dependent on individual discipline.

Purpose-built risk register software makes the review cycle structural rather than discretionary: scheduled review reminders that notify risk owners when a review is due; KRI monitoring that surfaces early warning signals between formal review cycles; treatment action tracking with automatic due-date reminders; incident linkage so that when an incident is investigated, connected risks are automatically flagged for review; and every change time-stamped and attributed, creating an automatic audit trail.

For a detailed look at what to look for in a platform, see Best Risk Register Software for Australian Businesses.

Frequently Asked Questions

How often should a risk register be reviewed as a minimum?

At minimum, every risk register should be formally reviewed at least once per year. However, annual-only reviews are rarely sufficient for organisations with dynamic operating environments, significant regulatory obligations, or a high proportion of high or extreme risks. Most governance frameworks, including the ASX Corporate Governance Principles and ISO 31000, expect organisations to maintain a risk register that is current and reflective of the actual risk environment, which requires more frequent review than annual.

What’s the difference between monitoring a risk and reviewing a risk?

Monitoring is the ongoing tracking of risk indicators and control performance, watching for early warning signals that a risk is changing. Reviewing is the formal, periodic reassessment of the risk’s likelihood, consequence, controls, and treatment actions. Both are necessary: monitoring tells you when a review is needed; the review is where you formally update the register in response to what monitoring has surfaced.

Should all risks be reviewed at the same frequency?

No. High and extreme risks warrant more frequent review than low or medium risks. Most risk management frameworks recommend that the top-tier risks be reviewed at least quarterly, while lower-tier risks can be reviewed semi-annually or annually. Your review schedule should be tiered by risk rating, not flat across the register.

What happens if a risk register hasn’t been updated in over a year?

An out-of-date risk register, particularly one that hasn’t been reviewed in more than 12 months, signals to auditors, regulators, and boards that the organisation’s risk management program is not functioning as intended. The practical first step is a full audit of the register: reviewing every risk for continued relevance, updating ratings based on current conditions, assessing the status of all treatment actions, and identifying any significant risks that may have emerged in the interim. This baseline reset then serves as the starting point for a regular going-forward review schedule.

Do you need a separate review process for compliance risks?

Compliance risks generally warrant the same review structure as other categories, but with additional attention to the regulatory calendar. Many compliance risks change on a legislated schedule, when new regulations take effect, or when existing reporting obligations come due. Embedding regulatory change monitoring into the review cycle means compliance risks are updated proactively rather than reactively.

Automate Your Risk Register Review Cycle with Lahebo

Lahebo’s risk management platform is built to make regular, evidence-based risk reviews sustainable, not just for large teams with dedicated risk functions, but for organisations of all sizes. With Lahebo, you can set scheduled review reminders that automatically notify risk owners when their risks are due for reassessment; track KRIs and receive alerts when thresholds are breached; connect incidents directly to risk register entries; monitor treatment action completion; and generate board-ready risk reports from live register data.

The result is a risk register that gets reviewed consistently, stays current between formal cycles, and gives your board the accurate risk intelligence it needs to govern effectively.

For an introduction to what a risk register should contain, see What Is a Risk Register? The Complete Guide for Australian Businesses.
