Top 5 Risk Register Mistakes Australian Businesses Make (And How to Avoid Them)

A risk register is only as useful as the discipline behind it. Built and maintained well, it’s one of the most powerful tools your business has, a live record of what could go wrong, who owns it, and what you’re doing about it. But a risk register that’s poorly constructed, neglected, or treated as a compliance checkbox is worse than no register at all, because it creates a false sense of security while doing nothing to actually manage risk.

Australian businesses of all sizes fall into the same traps. The good news is they’re all avoidable. Here are the five most common risk register mistakes, and exactly what to do about each one.

Mistake 1: Building It Once and Never Updating It

This is the single most common risk register failure, and it’s everywhere. A team spends two days in a workshop, identifies thirty risks, assigns ratings, and produces a polished risk register. It gets presented to the board. It gets saved to SharePoint. And then nobody touches it again for eighteen months.

By that point, half the risks on the register no longer reflect reality. New risks have emerged, from regulatory changes, new markets, new technology, or shifts in the competitive landscape, and nobody has logged them. Controls that were “in place” when the register was built may have changed or lapsed. The risk owners listed may have left the organisation.

What good looks like: A risk register should be treated as a living document, not a project deliverable. Schedule a minimum of quarterly reviews for high and critical risks, and an annual review of the full register. Build review triggers into your processes: any significant incident, near miss, major operational change, or regulatory update should prompt an immediate review of relevant risks. The review date and reviewer should be logged in the register itself.

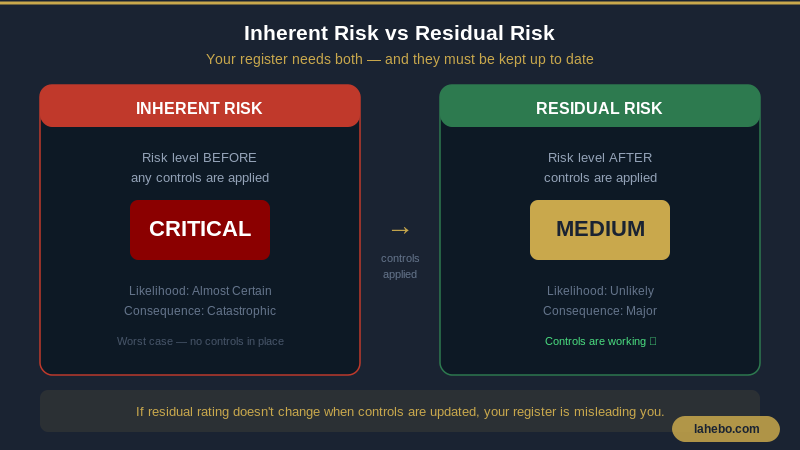

Inherent vs residual risk comparison, showing risk level before and after controls are applied
Inherent risk vs residual risk, your register needs both, and residual ratings must be updated whenever controls change.

Mistake 2: No Clear Ownership

A risk without an owner is a risk that nobody manages. Yet it’s extremely common to see risk registers where the “owner” column is blank, filled with a team name rather than an individual, or assigned to someone so senior they have no capacity to actively monitor it.

Ownership without accountability is meaningless. If the CFO is listed as owner of fifteen financial risks, and the CFO has no defined obligations or review cadence for those risks, the ownership field is just decoration.

What good looks like: Every risk in the register should have a named individual as owner, not a department, not a role, not a committee. That person is responsible for monitoring the risk, ensuring controls are in place, completing treatment actions by their due dates, and escalating when the risk profile changes. Risk owners should receive regular reminders and be held accountable through your governance cycle. If you can’t identify a specific person to own a risk, that’s a governance problem to solve before the register is finalised.

Mistake 3: Treating the Risk Rating as Set and Forget

When a risk is first assessed, it gets a likelihood and consequence rating that reflects what’s known at that moment. But risk ratings aren’t permanent facts, they’re judgements based on current conditions, and conditions change.

A risk rated as “unlikely” twelve months ago may now be “almost certain” due to regulatory change, market conditions, or something that happened internally. A risk rated “major” consequence may have been partially controlled so that residual consequence is now “moderate.” When ratings aren’t updated, the register loses its ability to help prioritise. High-risk items get treated the same as low-risk ones, and resources get misallocated.

The related problem: many organisations only record the inherent risk rating (before controls) and never record the residual risk rating (after controls). Without residual ratings, you have no visibility into whether your controls are actually working.

What good looks like: Every risk should have both an inherent and a residual risk rating. Ratings should be reviewed at each scheduled review, not just when someone remembers. If a treatment action is completed, a new control is implemented, a process is changed, the residual rating should be updated to reflect it. The risk register should show a history of how ratings have changed over time, so you can demonstrate that your risk management program is working.

Mistake 4: Overcomplicated Scoring That Nobody Understands or Uses Consistently

There’s a tendency in risk management to equate complexity with rigour. Some organisations build elaborate risk scoring systems with fifteen consequence categories, seven likelihood bands, weighted scores for different risk types, and adjustment factors for velocity and interconnectedness. The scoring methodology becomes so complex that different people applying it to the same risk produce wildly different results.

When your risk rating process lacks consistency, the register loses its credibility as a decision-making tool. A 5×5 matrix where two assessors produce different ratings for the same risk isn’t giving you information, it’s giving you noise.

The other extreme is equally problematic: a 3×3 matrix that’s too coarse to meaningfully differentiate between a risk that could cause a $10,000 inconvenience and one that could cause $10 million in loss and regulatory action.

What good looks like: Choose a rating scale that matches your organisation’s size and risk profile, then use it consistently. For most Australian businesses, a 5×5 likelihood × consequence matrix with clear, specific definitions for each cell is the right balance. The definitions matter: “major” consequence should mean the same thing to everyone using the register. Document your rating criteria and provide worked examples. Simple and consistent beats complex and inconsistent every time.

Mistake 5: Treating the Risk Register as a Compliance Exercise, Not a Management Tool

Ask many business owners or managers why they have a risk register, and the honest answer is: “because our insurer asked for one” or “because it came up in an audit.” That’s a legitimate starting point, external pressure can drive good practices. But if the register only exists to satisfy an external requirement, it will never deliver its real value.

A compliance-only risk register looks like this: it’s updated in the weeks before a board meeting or an audit, it captures the risks that are easy to articulate and uncontroversial, it skips the difficult or politically sensitive ones, and it’s forgotten the moment the audit is complete. The people whose job it is to manage operational risk day-to-day have never seen it.

What good looks like: The risk register should be integrated into how the business actually operates. Risk owners should reference it when making operational decisions. It should inform budget allocation, if a critical risk has an outstanding treatment action that requires investment, that investment should be prioritised. It should be a standing item in leadership meetings, not an annual box-ticking exercise. The goal isn’t a document that impresses auditors. It’s a process that helps your business identify what’s threatening it, take the right actions, and prove it’s doing so.

Risk register best practices checklist, six hallmarks of a well-maintained risk register
Six hallmarks of a risk register that actually manages risk, not just documents it.

Frequently Asked Questions

How often should a risk register be updated?

At minimum, high and critical risks should be reviewed quarterly, and the full register should be reviewed annually. Beyond scheduled reviews, any significant operational change, incident, near miss, or regulatory update should trigger an immediate review of relevant risks. The review cadence should be documented in your risk management policy and tracked within the register itself.

Who should be responsible for maintaining the risk register?

Responsibility typically sits with a Risk Manager, CFO, or Operations Manager, depending on the size and structure of the organisation. But maintaining the register is a shared responsibility: individual risk owners are accountable for their assigned risks, and leadership is accountable for ensuring the governance cycle runs. In smaller businesses without a dedicated risk function, the register is often maintained by the person with the broadest operational view, frequently the CEO or COO.

What should a risk register include?

A well-structured risk register should include: risk description and category, inherent likelihood and consequence ratings, the overall inherent risk level, controls currently in place, residual likelihood and consequence ratings, the overall residual risk level, the named risk owner, outstanding treatment actions with due dates and responsible parties, and the next scheduled review date. For a detailed guide to what goes in each field, see: How to Build a Business Risk Register.

What’s the difference between inherent and residual risk?

Inherent risk is the level of risk before any controls or mitigation measures are applied, essentially, how bad could this get if nothing was in place to manage it? Residual risk is the level of risk that remains after controls are applied. Both ratings should be in your register: inherent risk helps you understand the worst-case exposure, while residual risk tells you whether your controls are actually reducing it to an acceptable level.

Avoid These Mistakes with a Purpose-Built Risk Register

Spreadsheets can technically hold a risk register. But they can’t send automated reminders to risk owners, enforce consistent rating criteria across your organisation, track the history of rating changes, or connect your register to your live legislative compliance obligations.

Lahebo’s risk register module is built to prevent exactly the mistakes outlined above, with structured ownership assignment, built-in review scheduling, dual inherent/residual rating fields, and direct links to Australian regulatory and compliance requirements.

For a full walkthrough of how to structure your register from the ground up, see: What Is a Risk Register? The Complete Guide for Australian Businesses.
